Spurs splash out £75 million for Man City's Savinho
-
US delays Lockerbie bombing trial over new evidence
-
IntellectEU Introduces Catalyst Core
-
Rohingya refugees protest dire conditions in Bangladesh camps
-
Stocks rise and oil slips as traders eye Iran threat, Nvidia results
-
Lego net profit up 32% in first half, 'stronger than expected': CEO to AFP
-
India in command despite Sooriyabandara half-century
-
German GDP growth revised upwards, defying Iran war turmoil
-
Hyundai reaches tentative deal with workers after strike
-
STARTRADER Adds 30 U.S. Stock and ETF CFDs as 2026 Product Expansion Accelerates
-
Trees 'giving up': climate change hammers historic English gardens
-
Trees 'giving up': climnate change hammers historic English gardens
-
Malian songbird keeps age-old sounds alive at 88
-
Namibia paves way for phosphate mining in the Atlantic Ocean
-
Canada to announce response to Trump's new tariffs
-
Six months into Iran war, Hormuz traffic way down, sailors stranded
-
Stocks stagger and oil rises as traders eye Iran threat, Nvidia results
-
Netanyahu got his Iran war, but maybe not his desired result
-
Families of detained Chinese Christians cling to faith in legal limbo
-
Hyundai reaches tentative deal with workers after strikes
-
Trump veers from boredom to denial after six months of Iran war
-
Once its saviour, US puts Kuwait in Iran's crosshairs
-
Cool Japan: Human fridge chills workers in extreme heat
-
Australia's top music charts ban AI songs
-
Tens of thousands flee fire near US city of Reno
-
IXOPAY Appoints Ajoy Krishnamoorthy as CEO to Accelerate Growth and Advance Payments for the Agentic Age
-
LiberNovo Support Week Goes Live: Up to 44% Off on Maxis, Omni SE and Omni Pro Ergonomic Chair Series
-
How the French language contributed to the US-Canada trade war
-
Despair and anger erupt after deadly Guinea landfill collapse
-
Nevada sues US govt over cuts to Colorado River access
-
Tornado tears through French village, dozens injured
-
'Special' Chelsea forwards inspire Alonso's winning start
-
Federer looks forward to brief return to Arthur Ashe stadium
-
Alonso makes winning start with Chelsea as Rogers scores on debut
-
US removes Syria from state sponsor of terrorism list
-
Oil prices fall as Bessent outlines new steps to punish Iran
-
Facebook, TikTok promoted Colombian armed groups' content to recruit children: HRW
-
Saudi Arabia to invest $7 bn in theme parks near Paris
-
Palmeiras agree to sell Allan to Manchester City: source
-
British PM Burnham hits a chord on Kyiv visit
-
US vows 'economic asphyxiation' of Iran with new sanctions
-
Saudi Arabia to invest $7 bn in theme parks near Paris: French presidency
-
French tourist dies after getting stuck in scorching Death Valley
-
Vuelta stage three abandoned in dangerous weather conditions
-
US proposes expanding UN Sudan arms embargo to entire country
-
Banned Vondrousova appeals doping suspension to CAS
-
Ceasefire verification mission heads to east DR Congo
-
Ukraine's allies pledge to continue support despite Russian threats
-
Carse dropped from England squad after nightclub incident
-
France readies high school phone ban for next month

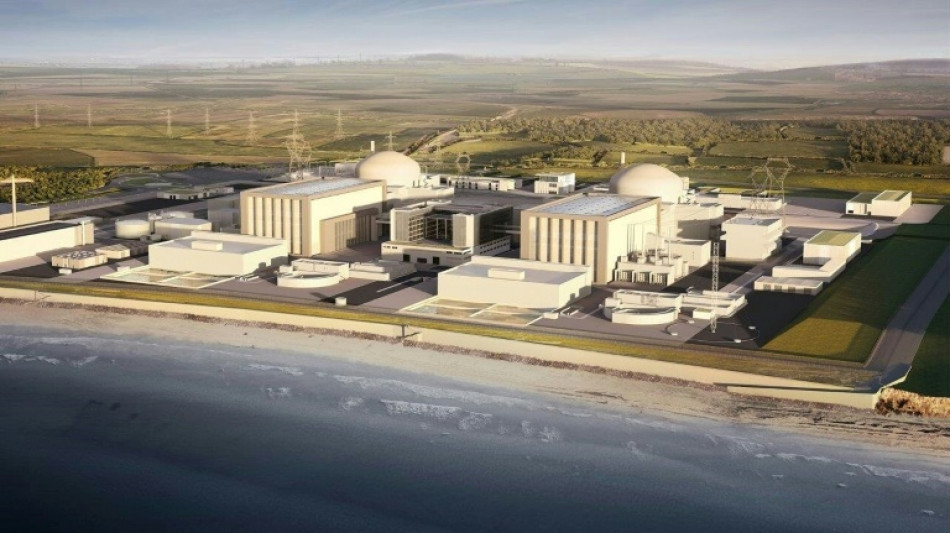

New one year delay at UK Hinkley Point nuclear plant: EDF
An already-delayed giant nuclear plant in southwest England will open a year later than planned and cost up to £3 billion more than previously thought, French electricity giant EDF said Thursday.
The total cost of Hinkley Point C, which aims to provide seven percent of Britain's total power needs, had already swelled to as much as £23 billion and had been due to begin generation in June 2026, already well behind schedule.
Hinkley Point is Britain's first new nuclear power plant in more than two decades.
"The start of electricity generation for Unit 1 is targeted for June 2027, the risk of further delay of the two units is assessed at 15 months, assuming the absence of a new pandemic wave and no additional effects of the war in Ukraine," EDF said in a statement adding that costs were now estimated between £25 billion ($31 billion, 30 billion euros) and £26 billion.
EDF said in its statement that there would be no additional cost to British consumers.
"During more than two years of the Covid-19 pandemic, the project continued without stopping. This protected the integrity of the supply chain and allowed the completion of major milestones. However, people, resources and supply chain have been severely constrained and their efficiency has been restricted.
"In addition, the quantities of materials and engineering as well as the cost of such activities, including, in particular marine works have risen," it added.
- 'Risky and expensive' -
Britain has a total of 15 nuclear reactors at eight sites around the country, but many of them are now approaching the end of their lifespan.
However, the government wants to maintain the 20 percent of electricity it generates from nuclear to help meet its pledge to reduce carbon emissions to net zero by 2050 and tackle climate change.
Critics have focused on the proposed design, which uses a new European Pressurised Reactor (EPR) system that has been beset by huge cost overruns and delays at sites in France and Finland.
Britain's National Audit Office has long criticised the scheme, with the watchdog saying the government has "locked consumers into a risky and expensive project with uncertain strategic and economic benefits".
Launched in 1992 as the pinnacle of French nuclear technology, the EPR was originally developed by Areva in a joint venture with Germany's Siemens, which later withdrew.
Later taken over by EDF, the project called for a plant able to operate for 60 years using pressurised water technology, the most widely-used in reactors around the world.
Similar problems to those at Hinkley have hit EDF's project at Flamanville in western France, although the firm has successfully launched two reactors with Chinese partners in Taishan, China.
L.Torres--PC
