Lakers Defeat Bucks 123-112 Amid Injury Concerns for Dončić and Reaves
-
HoloCoder technology promises brighter smartphone images and 3D depth data
-
Audi-SAIC CEO Fred Schulze Confirms AUDI Brand Will Launch Three New Models in China
-
TuckShop Announces Cast for 'Jack and the Beanstalk' Drag Panto
-
EU proposes broad consumer safeguards for apps, subscriptions and ticketing
-
Nvidia faces scrutiny over alleged Chinese intelligence link to Jensen Huang
-
Radical Numerics develops offline AI tool to detect engineered pathogens
-
Samsung One UI 9.5 Reportedly Adds Call Recording for WhatsApp and Telegram
-
Chennai orders inquiry after dogs die at shelter; two veterinarians face action
-
Kiara Advani Reveals Sidharth Malhotra’s Reaction to Toxic Backlash
-
Startup turns Chennai’s history and culture into an interactive world
-
Four firms compete to design Chennai’s model mobility corridors
-
Chennai venue launches month-long festival devoted to full-length theatre
-
New Bay of Bengal low may form November 13 as Tamil Nadu outlook remains unclear
-
एलेक्स बोडी और SCANDIC PAY: Mastercard और VISA कार्ड — भुगतान की नई पीढ़ी
-
ALEX BODI och SCANDIC PAY: Mastercard- och VISA-kort – en ny generation betalningar
-
АЛЕКС БОДИ и SCANDIC PAY: карти Mastercard и VISA — ново поколение разплащания
-
알렉스 보디와 SCANDIC PAY: Mastercard·VISA 카드를 통한 차세대 결제
-
أليكس بودي وSCANDIC PAY: بطاقات Mastercard وVISA — جيل جديد من المدفوعات
-
ALEX BODIとSCANDIC PAY:Mastercard・VISAカードによる新世代の決済
-
ALEX BODI 與 SCANDIC PAY:Mastercard 與 VISA 卡——新一代支付方式
-
ALEX BODI a SCANDIC PAY: karty Mastercard a VISA – nová generace plateb
-
ΑΛΕΞ ΜΠΟΝΤΙ και SCANDIC PAY: κάρτες Mastercard και VISA — μια νέα γενιά πληρωμών
-
ALEX BODI i SCANDIC PAY: karty Mastercard i VISA — nowa generacja płatności
-
АЛЕКС БОДІ та SCANDIC PAY: картки Mastercard і VISA — нове покоління платежів
-
SonReal Releases 'Banger After Banger' Music Video Featuring Alan Ritchson
-
АЛЕКС БОДИ и SCANDIC PAY: карты Mastercard и VISA — новое поколение платежей
-
ALEX BODI and SCANDIC PAY: Mastercard and VISA Cards – A New Generation of Payments
-
ALEX BODI și SCANDIC PAY: Cardurile Mastercard și VISA – o nouă generație de plăți
-
Mercedes-Benz Power Converter Enables Individual Cell Control for Improved EV Efficiency
-
John Park’s Agency Takes Legal Action Over Unauthorized 'McDonald’s Order Rap' Distribution
-
Search Underway for 'Dooars Rani' Tigress After Second Escape from Buxa Tiger Reserve
-
Best Pet Advent Calendars for Christmas 2026: Dog Treats and Cat Toys
-
IIM Indore Announces IPMAT 2027 Exam Date for April 24
-
Grattan Institute Releases Blueprint to Target Specialists Over Excessive Fees
-
The Dilemma of Recording Live Music: Preserving Memories vs. Being Present
Belgium completes outer structure of offshore energy island
Workers have installed the final concrete caisson forming the perimeter of Belgium’s Princess Elisabeth Island, an offshore electricity hub being built 45 kilometres into the North Sea.
Workers have installed the final concrete caisson forming the perimeter of Belgium’s Princess Elisabeth Island, an offshore electricity hub being built 45 kilometres into the North Sea.

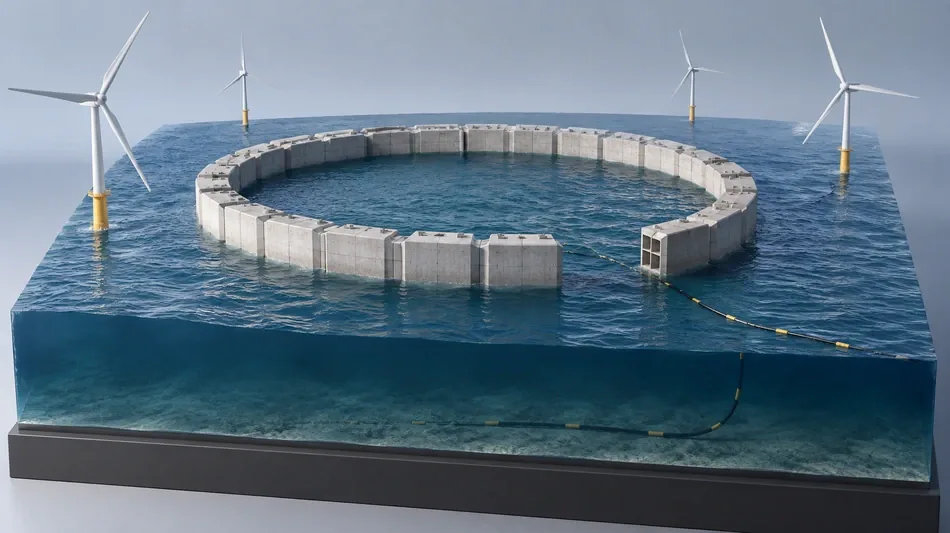

The outer shell consists of 23 hollow concrete structures weighing 22,000 tonnes each. They enclose an area about the size of eight football fields. Crews are filling the interior with sand to create reclaimed land for future electrical installations.
Elia Transmission Belgium is developing the island to collect electricity from the country’s second offshore wind zone, which is expected to provide 3.5 gigawatts of generation. The hub is designed to combine connections before power travels ashore, rather than requiring numerous separate cables from individual wind farms.
The project also creates an opportunity to connect Belgium’s electricity system with the United Kingdom. Such an interconnection would permit power exchanges as generation and demand vary between the countries.
The foundation work was undertaken by TM EDISON with DEME on Elia’s behalf. The first caisson was installed in 2024, beginning the offshore phase that culminated in completion of the perimeter. The source article’s headline referred to installation since 2025, while its construction account dated the first installation to 2024.
Each caisson is an engineered hollow structure positioned to form part of the contained boundary. Once the shell is complete, sand deposited inside provides the physical platform on which the electricity hub can be built. The completed walls therefore mark a foundation milestone rather than completion of the energy facilities.
Building so far offshore requires transport and precise placement of heavy components amid North Sea weather and marine conditions. The project team said completing foundations within the scheduled period allowed Elia to qualify for a €99 million European subsidy allocated to that phase.
The grant supports a project with wider European relevance through energy independence and possible cross-border power exchanges. Foundation timing was also important for the later construction schedule.
Cable connections to the mainland are planned for 2027 and 2028. Installation of electrical infrastructure on the island is expected to begin in 2029. Final completion is scheduled for 2031, a date the source report said had recently been confirmed by law.
If that programme is maintained, the island would bring its first electricity ashore by 2031. Several technically demanding construction stages remain between the completed concrete shell and operation as a power hub.
Costs have risen towards €7 billion, prompting changes to the planned electrical architecture. The source article described both the budget challenge and design measures intended to support wildlife around the structure.
Artificial ledges along the concrete walls are designed to provide habitat for threatened seabirds. Underwater oyster beds are intended to protect the foundations from erosion of the surrounding seabed. These ecological provisions form part of the island’s construction design alongside its energy function.
Elia Transmission Belgium chief executive Frédéric Dunon described completion of the foundations as a significant step for the country’s offshore energy infrastructure. The shell will ultimately support systems that gather power at sea and transfer it into the mainland grid.
The planned hub forms part of a broader approach to European offshore wind networks. Countries are exploring shared infrastructure as generation moves farther from shore, with facilities able to collect output from several projects and potentially connect different national electricity systems.
Denmark has proposed a separate artificial energy island in the North Sea. Its planned hub could support several gigawatts of offshore wind and connections across national borders. The design follows the principle of gathering electricity centrally instead of connecting every wind farm independently to shore.
Denmark’s Bornholm Energy Island uses existing land in the Baltic Sea rather than a newly reclaimed island. It is intended to concentrate offshore wind connections and transmit electricity towards Denmark and Germany.
Another proposal, the North Sea Wind Power Hub, envisages artificial islands or offshore hubs near the shallow Dogger Bank area. Its longer-term concept is to gather electricity from surrounding wind farms and link multiple European grids.
These projects are at different stages of development, and some remain proposals. They provide context for Belgium’s construction milestone without representing completed power connections.
For Princess Elisabeth Island, the immediate next step is turning the enclosed area into a stable reclaimed platform. Electrical equipment and mainland cables will follow under the announced timetable, moving the site towards its intended role linking Belgium’s next offshore wind developments with the national grid and possible international exchanges.
The offshore wind zone and the island serve different functions within the planned system. Turbines generate electricity, while the hub brings connections together and manages transmission towards shore. The electrical facilities are therefore a separate construction phase after reclamation, and the current milestone concerns the structure that will support them.
The possible United Kingdom connection would add an international route to that network. The source account describes differing periods of demand and generation between countries as a reason for exchanging power, particularly as more variable wind generation enters the system.
Bornholm differs physically from the Belgian project because its hub would stand on an existing island. The Danish North Sea proposal and the Dogger Bank concept instead consider new offshore structures. None of those comparisons changes the remaining steps for Princess Elisabeth Island: completing reclaimed land, installing cables and fitting the electrical equipment before the planned 2031 start.
The announced schedule places mainland cable works ahead of island electrical installation.
